459 bedrooms is a long way from the Passivhaus self-build stereotype.

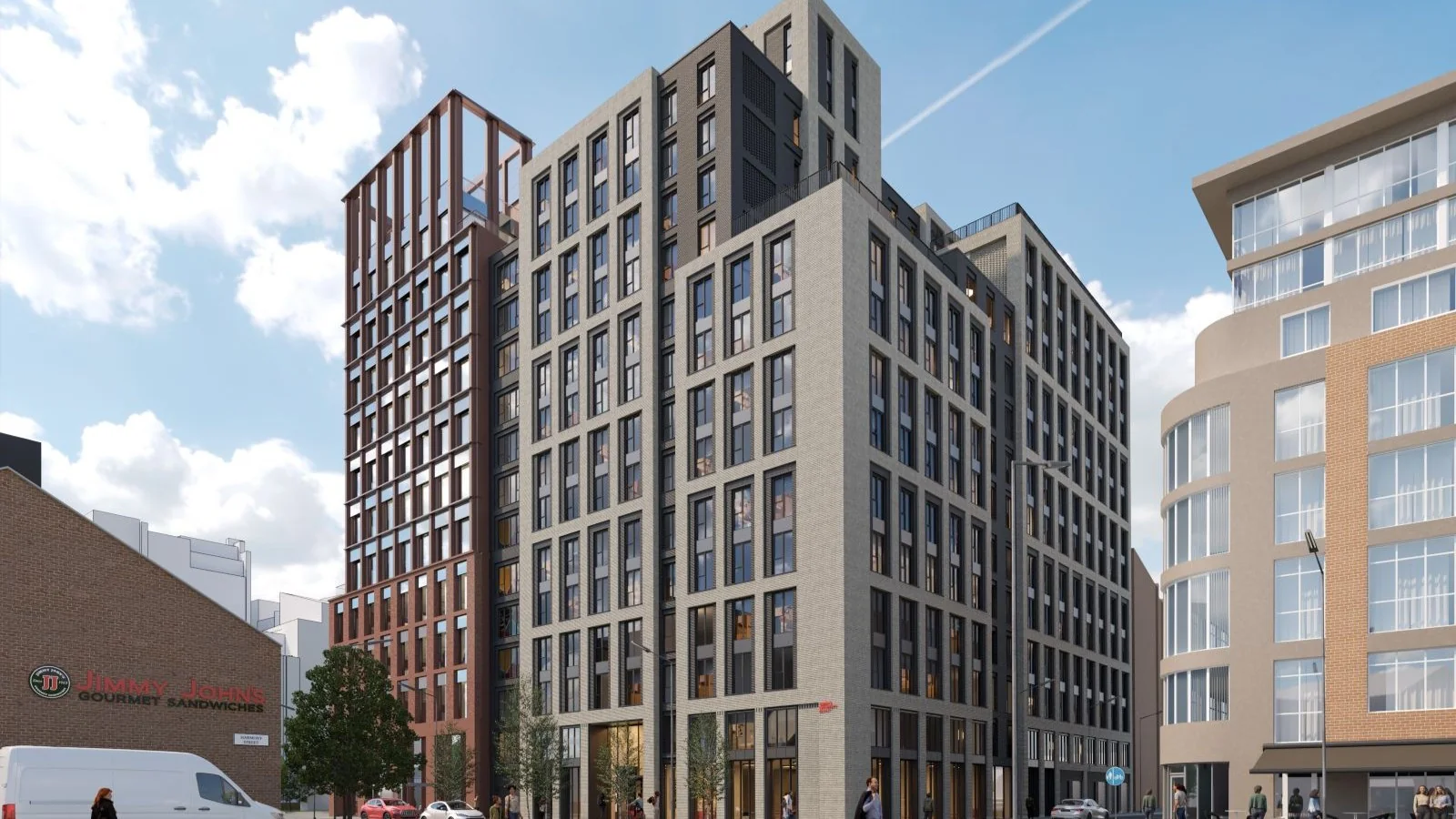

Weavers' Hall in Belfast is a student accommodation development for Queen's University Belfast. GRAHAM's case study explains how early contractor involvement helped the project team move from concept to site in just 12 months.
The scheme was designed to become Belfast's first certified Passivhaus purpose-built student accommodation development and, according to Bennett Freehill, the largest certified Passivhaus project on the island of Ireland.
But for me, the interesting part is not really the headline number. It is when the difficult conversations happened.
GRAHAM describes bringing the contractor, design team and specialist supply chain together from the start. Its case study identifies programme certainty, cost control, risk reduction and better technical solutions among the benefits. That matters once you start trying to deliver Passivhaus at this sort of scale.
Passivhaus details do not sit neatly in separate packages
A conventional project can sometimes get surprisingly far with individual packages developed fairly independently. Structure, insulation, services and groundworks progress, then everyone gradually tries to make the interfaces work.
Passivhaus makes that harder. Structure, insulation, airtightness, ventilation and buildability all meet in the same physical building. A junction is rarely just one consultant's junction.
If the structural solution changes, that can affect the insulation. If the wall build-up changes, that can affect the foundation detail. If levels change, that may affect drainage, thresholds and airtightness. On a larger building, the same detail may then be repeated hundreds of times.
That is why early coordination matters. Passivhaus need not make construction complicated, but it leaves less room to keep important decisions unresolved while the programme moves on.
I would rather spend a day or two looking at details 18 months before the job reaches site than spend one or two weeks trying to simplify them later.
The further a job progresses, the more every decision becomes attached to another decision. Changing the foundation later might mean revisiting the structural design, drainage, levels, wall construction, procurement and what has already been priced.
Something that looks like a fairly small change on a drawing can become a headache once five other packages have been designed around the original assumption. Weavers' Hall demonstrates the opposite approach: get the right people involved while they still have the ability to influence the job.
Passivhaus is moving well beyond bespoke houses
There is still a tendency to associate Passivhaus with one-off homes and self-builders. That is becoming harder to justify. Weavers' Hall alone brings Passivhaus principles into a 459-bedroom student accommodation scheme.
GRAHAM has since referenced Weavers' Hall while working on another Passivhaus student accommodation project for the University of Bath. During pre-construction, University representatives visited the Belfast development to gather practical insight that helped inform the Bath project.
We are seeing the same shift across schools, universities, social housing, student accommodation and larger residential schemes. Low-energy and Passivhaus principles increasingly apply to buildings where repeatability, programme and commercial reality matter just as much as theoretical performance.
We have seen that ourselves on the UEA Enterprise Centre, a Passivhaus-certified education and commercial building constructed by Morgan Sindall on an ISOQUICK foundation.
The challenge at that scale is not just achieving a good detail once. It is creating details that can be understood, coordinated and built repeatedly.
Foundations need to be part of that conversation early
ISOQUICK is an insulated raft foundation system designed for low-energy construction. It sits at the meeting point between the structural foundation, floor, wall construction, insulation envelope, ground conditions, drainage, services and site sequencing.
The useful time to consider it is not when somebody is about to start groundworks. By then, the structural concept may be agreed, levels set, drainage coordinated, the wall build-up detailed and packages issued for tender.
You can sometimes introduce a different solution late, but the earlier question is much more useful: does this foundation approach make sense for this project? Not: how do we force it into a job already designed around something else?
The wall-to-floor junction is a good example
Foundation strategy matters particularly on Passivhaus projects because of the wall-to-floor junction. You need structural support, thermal continuity, a wall construction that works with the slab, sensible airtightness detailing and something that can actually be built without improvisation on site.
Those things are connected. Our technical library includes standard foundation and wall-junction details across brick and block, timber frame, SIPs, ICF and other construction types. That information is more useful at design stage than when the concrete wagon is already booked.
Early involvement does not mean specifying everything at Stage 2
I am not suggesting that every specialist supplier needs to be fully specified before the building design has developed. Early involvement simply means examining realistic options before the project becomes expensive to change.
Sometimes a conventional foundation will be the right answer. Sometimes an insulated raft will make sense. Sometimes another solution will be better again. I would much rather look at a project early and say ISOQUICK is not the right fit than become involved six months later and try to force it into an unsuitable design.
The specialist supply chain knows things drawings do not always show
One of the strongest points in GRAHAM's account is its emphasis on specialist supply-chain involvement. A good specialist has seen their detail repeatedly. They know where installations become awkward, which details routinely create questions on site, what looks simple on a drawing but is complicated to build, and where coordination tends to fall apart.
That does not mean the supplier replaces the architect or structural engineer. In our case, the project structural engineer remains responsible for the structural foundation design and calculations. We work alongside them on the ISOQUICK layout, thermal specification and junction details.
For architects and design teams, we provide technical resources, CAD details and specification support for precisely that stage of the process. The specialist supply chain is most useful not as someone selling a product at the end, but as someone helping the design team understand the practical consequences of a decision early enough to act.
The scale is impressive. The process is more useful.
459 bedrooms makes a good headline. Moving from concept to site in 12 months while coordinating a complex Passivhaus development is probably the more useful lesson.
As Passivhaus moves further into mainstream construction, this becomes increasingly important. It does not necessarily mean adding more complexity. It means making some decisions earlier, involving the right technical people, examining interfaces properly and using specialist knowledge before the job reaches site.
It means trying to solve details while they are still drawings—not when they suddenly become somebody's problem on a Tuesday morning.
