An insulated raft foundation detail is not one generic section that can be dropped into every drawing package.
The basic intent is consistent: support the building while maintaining insulation beneath and around the reinforced concrete raft. But the critical work happens where that system meets the wall, external ground, door openings and below-slab services.
Those junctions affect structure, heat loss, moisture management, airtightness, accessibility and build sequence. Resolving them before construction is far easier than asking the groundworker, frame installer or membrane contractor to improvise around a poured slab. The companion guide to reducing thermal bridging at a floor slab junction explains how insulation continuity, wall position and the structural load path interact.
Start with performance, but do not stop at the U-value
A floor U-value describes heat flow through the planar floor element. A Ψ-value describes the additional linear heat flow at a junction, such as the external wall meeting the floor. They are different quantities and both can matter in SAP or PHPP.
The result cannot be read from the insulation thickness alone. Raft geometry, floor area and exposed perimeter, ground conditions, wall position and materials all affect the calculation. The relevant value should therefore come from the proposed project detail and the calculation convention being used—not from a visually similar standard drawing.
For Passivhaus projects, the same discipline applies to surface temperature and airtightness. A low calculated Ψ-value does not resolve the air-barrier connection, moisture route or structural load path. Each needs to be legible on the coordinated detail.
Treat a standard detail as the start of coordination, not evidence that every interface has already been designed.
1. Timber frame and SIPs: align the load path and moisture route
The first decision is where the sole plate sits relative to the edge of the structural slab. Moving the frame outwards may improve alignment between the wall insulation and perimeter insulation, but it can also leave part of the sole plate or stud outside the concrete bearing area.

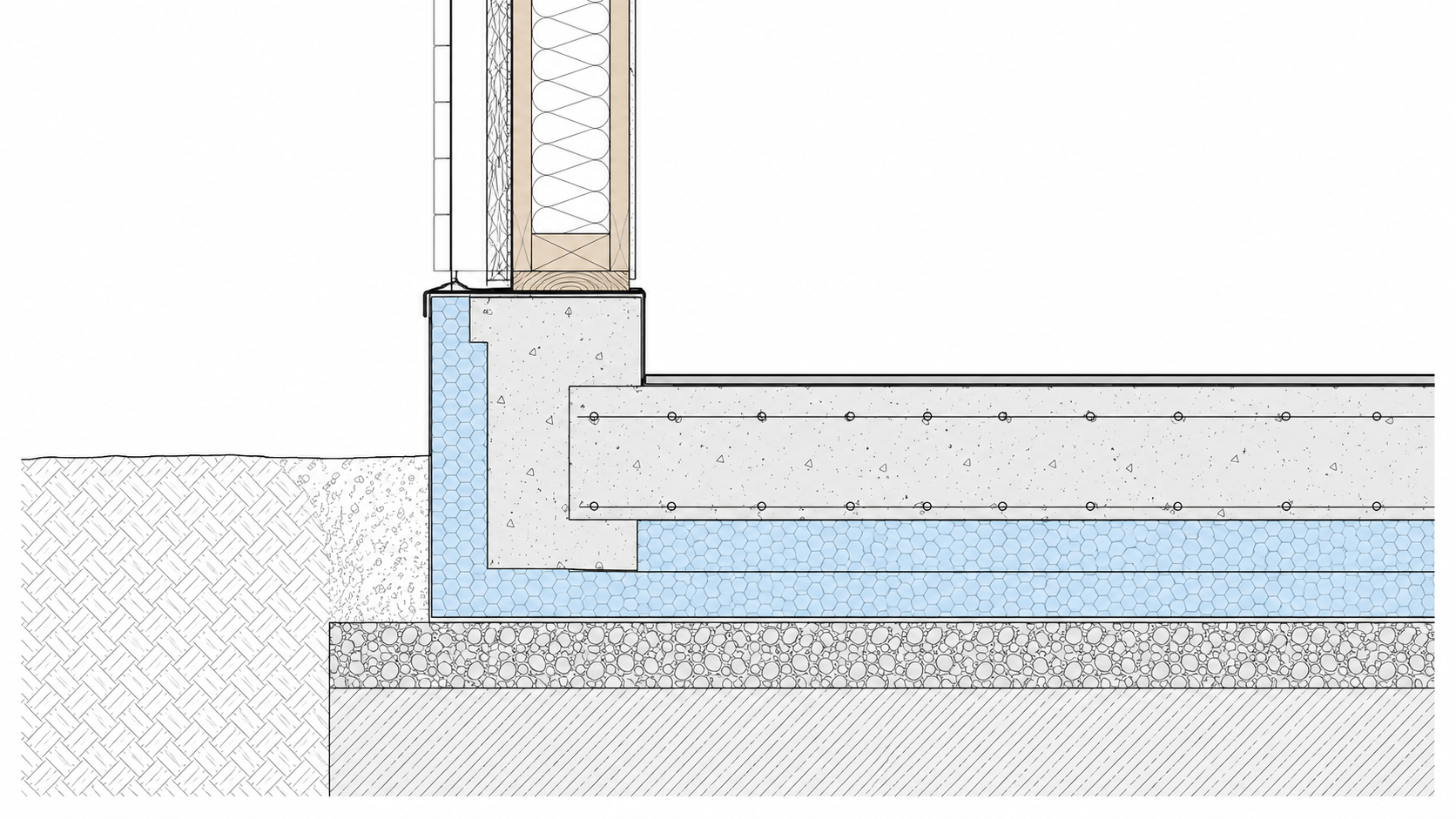

ISOQUICK's timber-frame and SIPs wall junction shows the standard relationship. Its accompanying sole-plate location guidance explains when an overhang needs explicit justification by the timber-frame structural engineer. The frame designer must establish how vertical, lateral and uplift loads pass into the raft and specify the sole-plate fixings; fixings close to the slab edge also require care.
Structure is only half the junction. Coordinate the DPC and DPM or ground-gas membrane, the airtight layer, the breather membrane, cavity tray or flashing, and drainage from the cavity. The detail must shed water outside the protected edge insulation without creating a trough at the base of the wall. Insect screens, ventilation openings and cavity barriers should also be shown where the wall system requires them.
2. ICF: support the concrete core, not just the insulation
An ICF foundation detail has a different load path. The reinforced concrete core of the wall is the structural element and must bear on the concrete raft; it should not overhang the slab edge. The widths of the ICF leaves, concrete core and perimeter profile therefore need to be selected together.
At external ground level, check how the exposed ICF insulation is protected and how the DPC connects to the DPM or ground-gas barrier. ISOQUICK's standard detail also notes that where the ICF outer insulation is less than 100 mm, an insulated plinth or flashing is required. The chosen render, cladding or plinth system must be compatible with the ICF supplier's requirements and the protective finish used over the raft edge.
The wall reinforcement, starter bars and raft reinforcement remain matters for the structural engineer. The thermal section should be developed alongside that reinforcement strategy, rather than after it.
3. Masonry and brick plinths: decide what carries the outer leaf
For masonry, the design team needs to distinguish between the loadbearing wall and any outer brick leaf. A brick plinth, cavity wall or masonry inner leaf can alter the edge geometry, reinforcement and moisture detailing considerably.
ISOQUICK publishes a brick plinth section detail and separate brick-support details. In the brick-support arrangement, the outer leaf is carried on a project-designed perimeter reinforced-concrete beam linked to the main raft with low-conductivity composite supports. Reinforcement and support spacing are engineered for the actual loads.
The DPC, cavity tray, weep vents and DPM position must be chosen as a coordinated system. Different published options place the DPM beneath the slab, above it, or use a waterproof-concrete approach. They are alternatives, not layers to combine casually. The external ground level, required upstand, cavity drainage and any site-specific interstitial-condensation assessment should all be settled before the edge profile is ordered.
4. Door thresholds: solve access, drainage and support together
A low threshold interrupts the normal perimeter upstand exactly where several demands converge. The door or sliding system needs reliable support; the insulation and membrane need continuity; external water needs a route away; and the entrance may need to satisfy the accessibility strategy.
Set finished internal and external levels early, using the applicable regulations for the nation and building type. In England, Approved Document M calls for accessible thresholds at relevant dwelling entrances; project requirements vary across the UK and between dwelling categories. Do not assume that “level access” means omitting falls or drainage.
The ISOQUICK low-level threshold detail shows a loadbearing thermal support, anchors, a slot drain and a sealed membrane connection. Its capacity depends on the support dimensions, overhang, fixings and spacing, so the exact door loads and frame geometry need to be supplied. Coordinate drainage outlet levels, waterproofing, door-manufacturer tolerances and the structural fixing zone before manufacture.
5. Services and penetrations: freeze routes before reinforcement
Below-slab drainage and incoming services are difficult to move once insulation, membranes and reinforcement are installed. The coordinated foundation plan should locate every foul and surface-water connection, duct, sleeve and service entry, including invert levels, gradients, bend radii and access for testing or maintenance.
ISOQUICK's drains and ducts detail shows penetrations cut through the insulation, gaps made good, and top-hat seals to the DPM. It also shows a swept bend and a rocker joint outside the building perimeter. Where fire resistance is required, the fire-stopping system must be specified for the service, substrate and required rating rather than inferred from the thermal detail.
Where a radon or other ground-gas protective measure is required by the site assessment, continuity becomes especially important. Use a compatible barrier system, proprietary seals or top hats at penetrations, sealed laps and a tested junction to the wall DPC. The full radon protection detail illustrates ISOQUICK's typical perimeter approach, but the gas-protection designer must specify the project solution.
An architect's pre-construction checklist
- Confirm the proposed wall build-up, dimensions and structural bearing line.
- Issue design loads and agree responsibility for raft, wall and secondary-leaf support.
- Calculate floor U-values and junction Ψ-values from the project geometry and chosen convention.
- Trace the insulation, airtight layer, DPC, DPM and any ground-gas barrier continuously on the section.
- Fix finished floor, threshold, paving and drainage levels.
- Obtain door-frame loads, fixing zones and threshold-support requirements.
- Coordinate every drain, duct and penetration before the reinforcement drawings are finalised.
- Review cavity drainage, weep vents, flashings, edge protection and external ground clearance.
- Record which details are typical and which require project-specific engineering or specialist design.
A successful Passivhaus foundation detail is not simply one with plenty of insulation. It is one in which the thermal, structural, moisture, airtightness and construction strategies describe the same buildable junction.
